Upper Westside Specific Plan
Project Summary
The proposed Upper Westside Specific Plan (UWSP) area consists of approximately 2,066 acres located east of Interstate-80, north and west of Garden Highway, and south of the drainage canal and Swainson’s Hawk Park in the Natomas Community. The UWSP establishes a framework and strategy for development of the Plan Area, including proposed land use designations, development and operation polices, and plans for infrastructure and public services. The Plan provides for 9,356 housing units with a mixture of densities that supports all population segments; 1,532-acre Development Area; a 534-acre agricultural buffer along the western edge of the Plan Area; 10 active parks; and an extensive system of greenbelts and multi-use trails with linkages to downtown Sacramento.

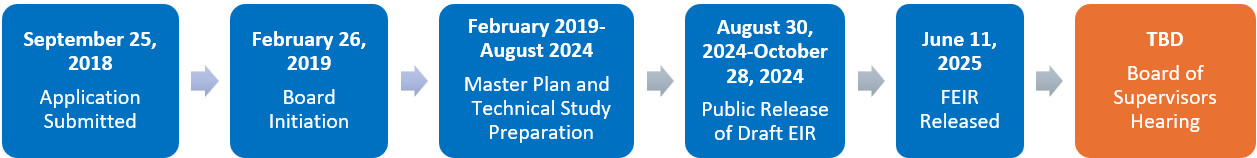

Project Timeline
| Date | Project Milestone |
| September 25, 2018 | Application Submitted |
| February 26, 2019 | Board Inititation |
| February 2019 - August 2024 | Master Plan and Technical Study Preparation |
| August 30, 2024 - October 28, 2024 | Public Release of Draft EIR |
| June 11, 2025 | FEIR Released |
| June 16, 2026 | Board of Supervisors Hearing |
Updates and Upcoming Events
Board of Supervisors: The Board of Supervisors is scheduled to consider the Upper Westside project during the June 16th hearing. The meeting agenda and agenda packet will be available here once materials are posted.
Specific Plan Supporting Documents
- Specific Plan Project Area
- Draft Specific Plan
- Draft Development Standards and Design Guidelines
- Draft Land Use Plan
- Draft General Plan Amendment - Urban Policy Area and Urban Services Boundary
- Draft General Plan Amendment – Land Use Diagram
- Draft General Plan Amendment – Active Transportation Plan
- Draft General Plan Amendment – Circulation Diagram (Roadway and Transit Component)
- Draft Roadway Master Plan
- Draft Public Facilities Financing Plan
- Draft Urban Services Plan
Environmental Documents
- Notice of Availability
- Partially Recirculated Final Environmental Impact Report
- Partially Recirculated Draft Environmental Impact Report
- Draft Environmental Impact Report (DEIR)
- Final Environmental Impact Report (FEIR)
- Appendix_INT-1_NOP
- Appendix PD-1_Proposed GP Text Amendments
- Appendix AQ-1_AQ and GHG Impact Analysis
- Appendix BIO-1_Supp Biological Resources
- Appendix BIO-2_Biological Resources Assessment
- Appendix BIO-3_Plant_Wildlife Species List
- Appendix EN-1_Energy Estimates Report
- Appendix HAZ-1_Phase I Env Site Assessment
- Appendix HYD-1_Master Drainage Study
- Appendix HYD-2_UW Flood Inundation Propagation
- Appendix NOI-1_Noise Vibration Report
- Appendix TR-1_Transportation Impact Analysis
- Appendix TR-2_Local Transporation Analysis
- Appendix UT-1_Water Supply Analysis
- Appendix UD-1_Urban Decay Analysis
- Appendix RTC-1_Comments on the DEIR
- Technical Appendix to Upper Westside Final Local Transportation Analysis, March 2022
- Technical Appendix Upper Westside Final CEQA Transportation Report, March 2022
Draft Environmental Impact Report Public Comments
- Recirculated DEIR Public Comments
- Written DEIR Public Comments
- CPAC Comments during DEIR Public Meeting
- COPC Comments During DEIR Public Meeting
Frequently Asked Questions
A detailed policy plan that identifies allowable land uses and infrastructure needs for a specific geographic area. Specific Plans typically include a land use plan, policy document, transportation plan, drainage plan, water supply plan, public facilities financing plan, urban services plan, and more. Specific Plans are intended to be a comprehensive guide for the physical development of a community at a more detailed level than the General Plan. Future zoning, subdivision, and public works decisions must be in compliance with adopted Specific Plans. Specific Plans are authorized by California Government Code Sections 65450-65457. They can be as general as providing broad policy concepts or as detailed as providing direction for every aspect of development.
Specific Plans may be either primarily applicant or may be a collaborative effort between the County and Plan proponents. The County is the governing jurisdiction and lead agency. In this case, the Applicant submitted proposals and materials to the County. The County reviews these proposals for consistency with the General Plan and other policy documents; assesses the potential environmental impacts of a proposal; coordinates with other County departments and government agencies such as neighboring jurisdictions, Water, Fire, Sewer, Air Quality, and Parks districts, and State and Federal agencies; conducts public outreach; and ultimately determines whether to approve or deny the Specific Plan. Upon adoption the Specific Plan is implemented through development proposals which the County reviews for consistency with the Specific Plan.
In response to separate development proposals in the Natomas Basin by the City and County of Sacramento in the 1990s, both jurisdictions recognized the benefits of coordinating their efforts. This collaboration led to the creation of the City/County Joint Vision for Natomas, formalized through a Memorandum of Understanding. This agreement outlined a shared vision for land use and revenue-sharing principles in the Natomas area. As part of this initiative, four planning areas or "precincts" were designated within the Natomas Joint Vision Area: Grandpark (formerly the North Precinct), the West Precinct, the South Precinct, and the Upper Westside (previously known as the Boot Precinct). In 2011 the Natomas Joint Vision Study Area overlay was added to the General Plan land use diagram. The intent of this overlay was to identify land within the vision area where the expansion of development was planned. As the Plan Area is outside of the Urban Policy Area and Urban Services Boundary, development of this area requires preparation of a master plan. In this case, the applicants propose a Specific Plan, one of many comprehensive master-planning tools.
Large scale development can be impacted by many factors such as global and domestic politics, economic conditions, and supply chains. The Upper Westside Specific Plan has a build-out is anticipated to occur over a 20-year timeframe. Typically, infrastructure and residential development will proceed first in order to attract a critical mass of residents needed to support commercial and institutional uses. The pace of construction could average approximately 468 dwelling units and 155,000 square feet of non-residential development per year.
The Upper Westside Specific Plan provides for future development. It does not require current property owners to do anything with their properties. Existing uses, such as residences and businesses, may continue to exist and operate until such time that the property owner chooses to pursue new development or a different use. If adopted, the Upper Westside Specific Plan would allow for development consistent with its proposed land uses and policies. Development consistent with the proposed land uses will require planning entitlements such as a Rezone, Tentative Subdivision Map, and Design Review.
Please refer to the Project Timeline on this page or contact the County for specific information.
